Production Process

Production process

How a bamboo order runs from work order to container

Six stages, each with the days it takes, so you can see where the time in a 45 to 60 day order actually goes. Fabric, cutting, sewing, inspection and packing all happen in our own 12,000 m² works in Weifang, and the last stage is the container leaving.

6 stages 45 to 60 days 100% inspection DDP freight
6 stages
Work order to loading
45-60 days
Typical bulk order, stage by stage
14 people
In-house design team on your tech pack
100%
Final inspection and needle detection

Stage by stage

Six stages, and the days each one takes

The days below are working days from a confirmed work order, not from the first enquiry. Sampling sits before this clock starts.

Stage Order step What happens Days
1 Confirm sample, fabric and design Style, size run, fabric, colour or artwork, trims and packaging are gathered into one work order. 2 days
2 Prepare fabric and trims Bulk fabric has to match the approved swatch and trims the approved sample. Stock qualities can be dyed or printed straight away; custom-greige fabric adds 15 days of weaving. 17-23 days
3 Fabric inspection and cutting Fabric is relaxed, then checked for shrinkage, colour fastness, weight, width, skewing and soiling. Cutting follows the approved marker. 5 days
4 Sewing and first inspection Sewing, then a first inspection for skipped stitches, agreement with the approved sample, correct trims and the correct thread colour. 15-22 days
5 Final inspection, needle detection, packing 100% inspection for loose threads, seams, measurements, soiling, colour match and trims, then hangtags and packing to the order spec and needle detection on every piece. 5-7 days
6 Cartoning, freight and dispatch Shipping list, transport method and DDP freight, timing confirmed with the buyer, balance payment, loading, then arrival and delivery updates. 1 day

Confirmed work order to container loaded

45 to 60 days

The range comes from fabric. Everything else is fixed at 2, 5, 15 to 22, 5 to 7 and 1 day; fabric is 17 to 23 depending on whether the quality is in stock or has to be woven.

Baifei designer preparing a pattern at the CAD workstation
Before stage one

Technical support and service

Your tech pack, our pattern room

A 14-person design team builds the sample from your TECH PACK, so the first round arrives in the shapes your shelves already carry rather than the shapes ours happen to be.

Every customer signs a confidentiality agreement as standard, before the pack is opened. It is not something you have to ask for.

Inside the stages

What the checks look like on the floor

Fabric rolls and trim shelving in the Baifei warehouse
Stage 2, fabric and trims

Bulk rolls pulled against the approved swatch, trims against the approved sample.

Fabric measured flat for shrinkage and width before cutting
Stage 3, fabric inspection

Relaxed, then measured flat for shrinkage, width and skewing before the marker is laid.

Colour and weight checked under a light box in the lab
Stage 3, colour at the light box

Colour fastness and weight checked against the approved standard, not against memory.

Garments packed and passed through needle detection
Stage 5, needle detection and packing

100% inspection, then hangtag, pack and needle detection on every piece.

One-shop factory

Nine operations, all under our own roof

Nothing on this list is subcontracted, which is why the stage timings above can be quoted instead of estimated.

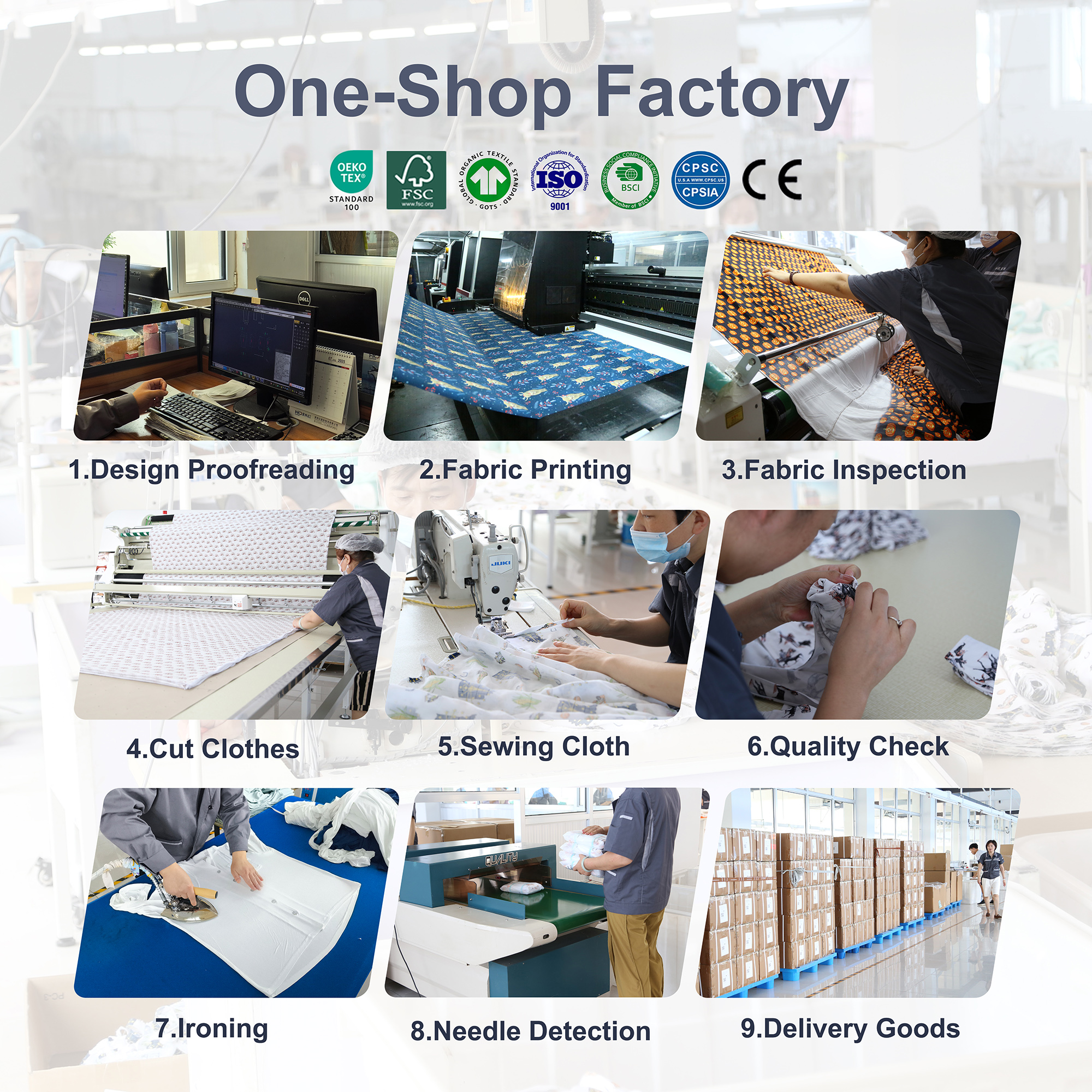

One-shop factory poster listing nine in-house operations
One-shop factory
  • Design prototyping

  • Fabric printing

  • Fabric inspection

  • Cut clothes

  • Sewing cloth

  • Quality check

  • Ironing

  • Needle detection

  • Delivery goods

Questions

What buyers ask about the timeline

How long does a bulk order actually take?

Between 45 and 60 days from confirmed work order to loading, which is the sum of the six stages above. Order confirmation takes 2 days, fabric and trims 17 to 23, inspection and cutting 5, sewing with first inspection 15 to 22, final inspection and packing 5 to 7, and dispatch 1.

Which stage do orders wait on longest?

Fabric, every time. Stock qualities can be dyed or printed as soon as the swatch is approved, but custom-greige fabric adds 15 days of weaving before the fabric even reaches inspection. That single variable is why the total is quoted as a range.

What is inspected, and at which stage?

Three times. Fabric is inspected before cutting for shrinkage, colour fastness, weight, width, skewing and soiling. The first inspection after sewing checks stitches, agreement with the approved sample, trims and thread colour. Final inspection is 100% of pieces: loose threads, seams, measurements, soiling, colour match and trims, followed by needle detection through every piece.

Do you sign an NDA over the tech pack?

Yes, as standard, not on request. A 14-person in-house design team builds the sample from your tech pack, and every customer signs a confidentiality agreement before the pack is opened.

How does shipping and payment work?

Freight is quoted DDP, with the transport method and timing confirmed with you before booking. A shipping list is issued, the balance is settled, then the container is loaded and you get arrival and delivery updates through to the port.

Send the tech pack and we will date the stages for you

Tell us the style, the size run and the delivery market. We will come back with the stage dates for your quantity and the freight route to your port.

Contact us →
